Planning
The planning process includes the following actions:
Writing a scope statement
Developing the WBS (Work Breakdown Structure)
Building a project schedule
Planning for acquiring resources
Creating a budget
Assigning roles and responsibilities
Planning how and when to communicate
Planning for risk
Planning how to monitor and control the project
Writing a Scope Statement
The scope statement builds upon the description created in the project charter in the initiating process. It sets the goals for what will be accomplished in your project. Aim to make your goal as specific as possible and measurable so you can determine if your goals are achieved.
A project scope statement describes the work that will be done and what will not be done to create the project’s unique outcome.
For example, you know you will need to prepare a verbal presentation, engineering portfolio and build a pit display so these items must appear in the scope statement. You also know that STEM Racing is a team competition so no individual work needs to be submitted and individual work would not appear in the scope statement. You should read the competition regulation carefully and list all the deliverables you are going to be expected to deliver. These are your guidelines and standards.
Developing the WBS / Planning for Quality
Work Break Down is one of the most important documents. It is developed in the planning phase. It is defined in the PMBOK as a hierarchical decomposition of the total scope of work to create the project deliverables. The WBS is the foundation to define the activities to develop the schedule. It allows the creation of the budget, estimating the activities cost, the work package's main components, and the deliverables. It permits the definition and link of the resources with the activities, identification of risk for the project and requirements and necessities of the people to protect them from harmful activities during the execution.
The WBS partnering with the project scope statement forms the scope baseline. This baseline is the fundamental part of scope validation to obtain the acceptance deliverable document signed by the client.

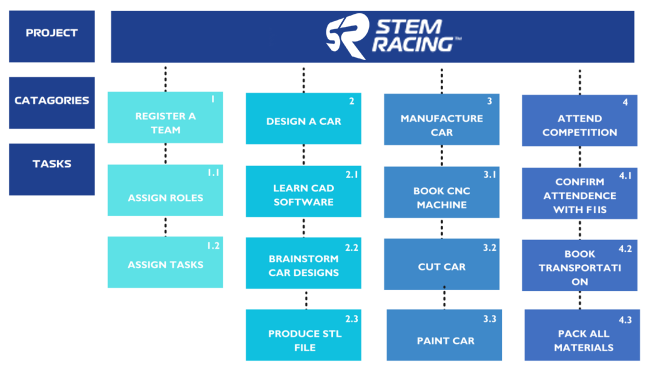

The WBS is developed using only noun words, and every branch goes from the general to the description; for example, the car body is at the general level or top to the level, design of the car body. The level is called the work package; it represents all the activities involved in designing and calculating the car body
A technique you can use to verify that the quality standards have been met is called acceptance criteria. You can define acceptance criteria for the entire project or specific deliverables. The below example demonstrates the quality acceptance criteria that could be implemented for your car development.
Planning when and how to monitor and control the project
Each part of the planning process builds on the others. You may find that you need to revisit and revise parts of your project along the way. This process of review and revision is part of monitoring and controlling your project. Monitoring and controlling will be easier to conduct with ongoing check-ins.
Take a moment to plan how frequently you will schedule check-ins with your team and project sponsor and how you will document the progress you are making. You may decide to check in hourly, daily, or weekly.
Building a Project Schedule
A project schedule needs to be created, identifying all the tasks to be completed including their start and due dates. The following steps should be undertaken:
Determine the major categories of work:
These categories can be established in several ways.
By PHASES: What should be accomplished pre competition, during competition, etc?
By MAJOR PIECES OF WORK: what should be accomplished for the design of the car, the manufacture of the car, creation of the enterprise portfolio, etc.
By MILESTONE: Milestones are the critical points in a project's timeline that can be monitored to determine if the project is on schedule. They show completion of major pieces of the project.
Define tasks:

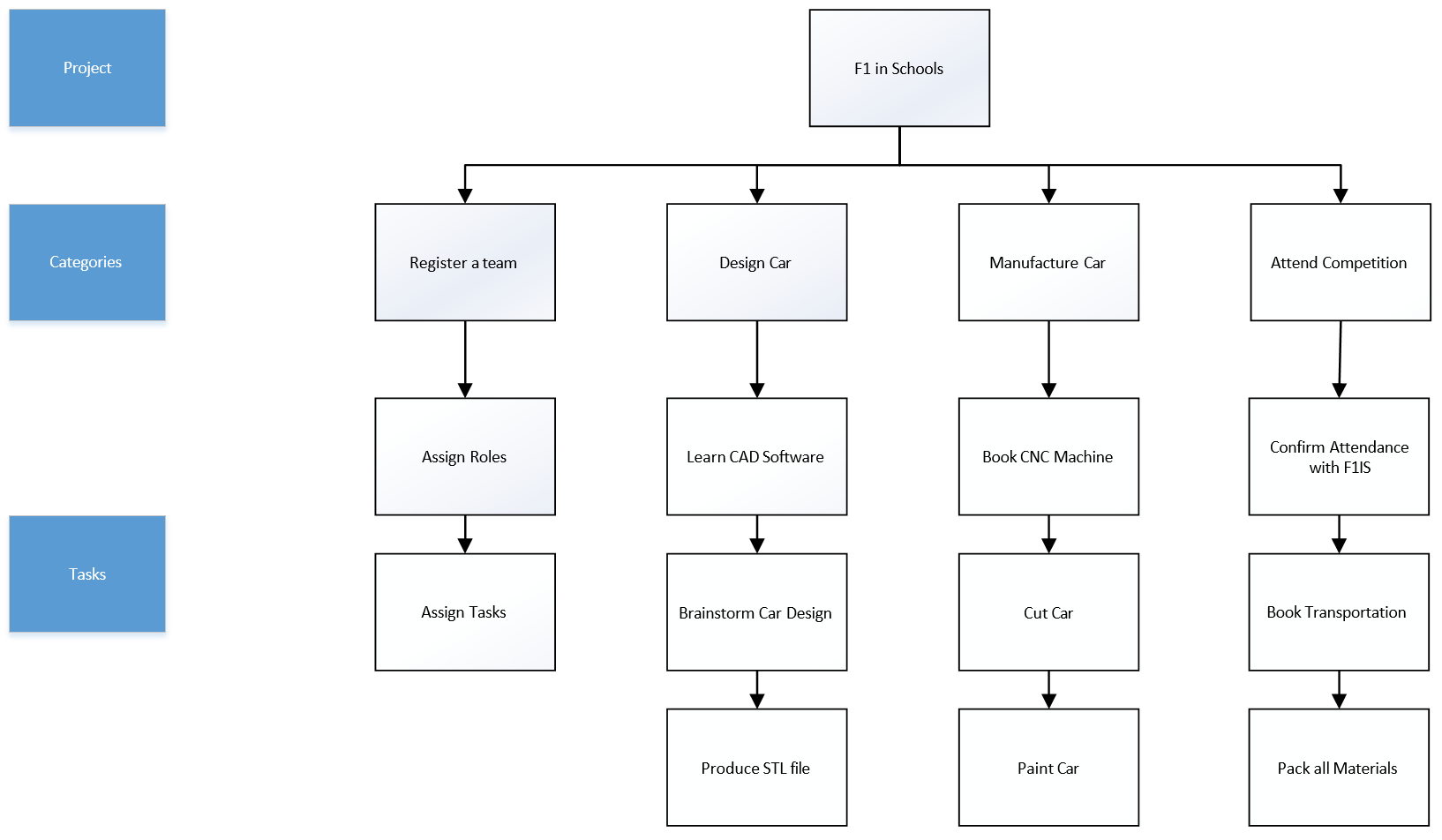

What tasks need to be accomplished to meet each milestone? Tasks are the “to-do” list. Breaking out the categories and tasks in this way is called a Work Breakdown Structure (WBS)
Determine the sequence:
When will each task be accomplished? To determine this sequence, you will need to assess which tasks are dependent and which are independent.
A dependent task means another task must be completed before the dependent task can begin. A very basic example… You will need to design your car in CAD before you can manufacture it so manufacture is dependent on the CAD work being completed.
An independent task means the task can be completed at any time and is not related to some other task being completed.
Estimate time:
How long will each task take to be completed? This is your best guess based, perhaps on experience or after discussion with your team, considering the amount of work to be done. Underestimating the amount of time needed to complete each task is a common error. Building extra time into the schedule can help ensure you have the time needed to complete your project on time. As you will be attending an event final you have a hard deadline that cannot be moved. Running out of time could mean not finishing your car or other judged work.
Build the schedule:
With all the above information in hand, it is now possible to build the schedule. There are many tools you can use to create your schedule such as table in Word, a chart in Excel or other project management specific software that can generate a Gantt chat such as Microsoft Project, Smartsheet, miro.com or projectmanager.com. Speak with you school to see what tools you are able to access.
Assigning Roles and Responsibilities
It is important to assess the strengths, skills, and abilities of each team member to effectively assign responsibilities to the best-equipped individual(s). A Responsibility Assignment Matrix (RAM) can be used to assign team members to appropriate tasks. A STEM Racing team will be very structured, the rules and regulation documents highlight the roles that a team should have. This does not limit you assigning other roles to team members.

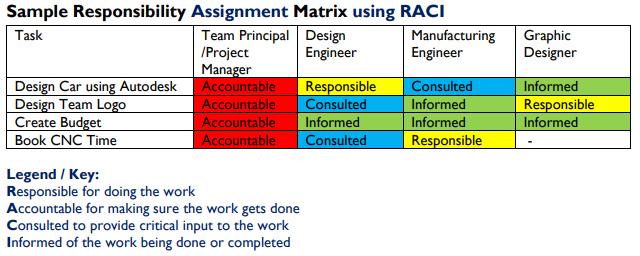

It is important to ensure that each activity and task identified in the project schedule is allocated to a team member. Assess the strengths, skills, and abilities of each team member to assign responsibilities effectively. Use a Responsibility Assignment Matrix (RAM). A legend or key is usually applied to the RAM, the one most used is known as RACI (Responsible - Accountable - Consulted – Informed), to assign team members to tasks.
Planning for Acquiring Resources

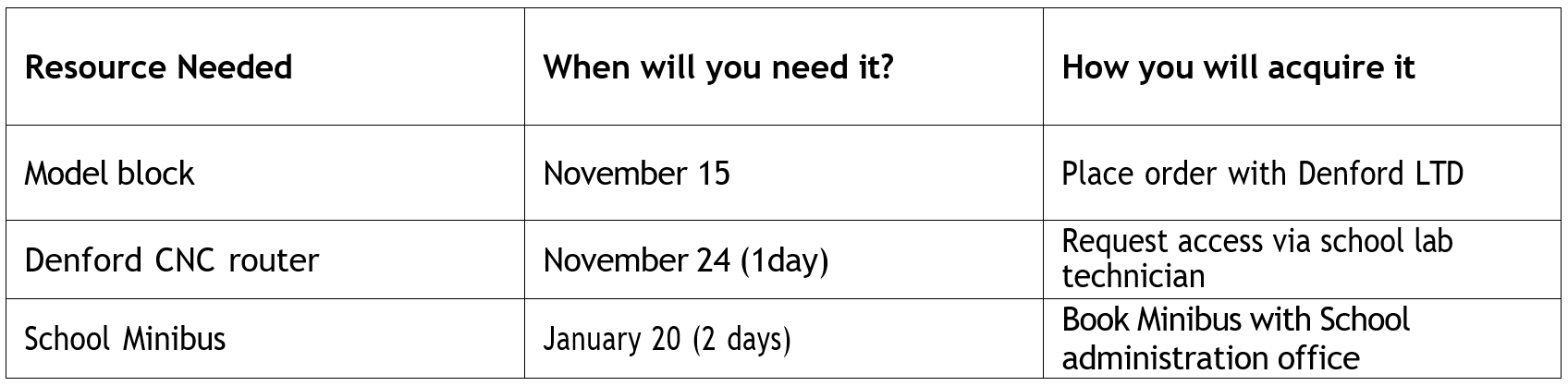

Resource planning considers all the things needed to complete the project. This may include people, money, equipment or even space needed to do the work. In the planning process you will need to determine where and how you will acquire each resource, when each resource is needed and how long you will need it.
Creating a Budget
A budget is a financial plan for income and expenditure over a defined period. The best technique to create a budget is using the bottom-to-top technique in the WBS to estimate the cost of every work package until the top, the deliverable. The WBS will allow us to attach resources, equipment, and materials to complete every work package and its corresponding deliverable. You will need to:
Identify what items will cost you money and how much they will cost. It is normal for costs to initially be estimated and your budget should include the actual costs so you can identify any over or under spend.
Identify where you plan to acquire the money. A fundraising event, sponsor pitch or a donation.
Agree who will be responsible for the budget and keep a record of spending and approve any purchases.
There can be many different costs associated with an entry to STEM Racing, some of which may not be immediately obvious or expected. For example, they may be associated with risks you have identified or unexpected changes that you need to make as you develop your car. There may also be a scenario where items cost more than you expected, and you need to ensure your budget can accommodate all these. In finance this is called the budget contingency. You can decide how much contingency you need by assessing how likely each of the scenarios presented above are likely to happen.
Tip: Budget Management can also be illustrated in pie charts, bar charts, etc., depending on what you would like to show. You might want to consider including the Project’s Cash Flow.
Planning when, what and how you will communicate
Team members and stakeholders need information on how the project is developing and what may need to change to get all the work done. Planning for communication involves having a clear understanding of who needs to communicate with whom and how often, as well as what information would be relevant and useful to each stakeholder.

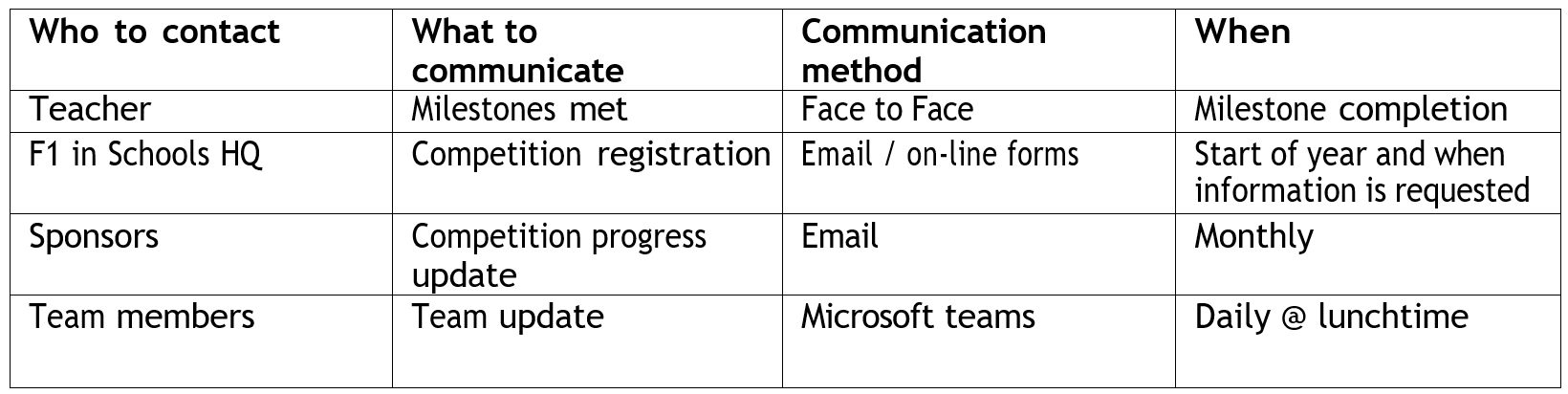

It is very important to have an internal project team communication plan. You should agree how you plan to communicate, how often, where and when. Look at the various communication tools that are available to you in case you cannot always meet in person.
Planning for Risk

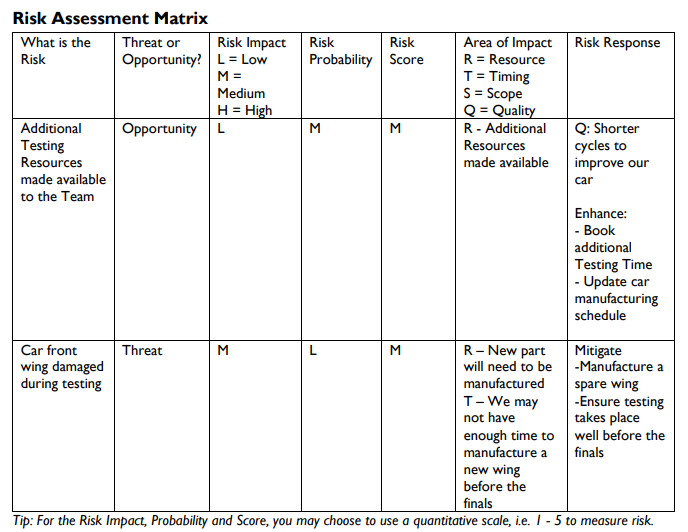

It is important to identify possible risks that might impact the successful outcome of the project. Identifying potential risks provides the opportunity to plan a response in advance that will help to avoid or minimise a negative impact on the project.
Risks could impact one or more areas of the project, including:
Resources: Ability to acquire people, equipment, funding, or other resources to complete project. All of these apply to STEM Racing.
Timing: Will deliverables or the entire project be completed on schedule? This is critical for STEM Racing as you have a hard deadline of attending an STEM Racing Regional or National Final event.
Scope: Completing and delivering all the items named in the original scope. You may choose to change the class of the competition you have entered.
Quality: How well each deliverable meets the goals set in the acceptance criteria. Has your car been manufactured as expected?
KEY TERMS:
Milestone: a significant point or event in a project, program, or portfolio
Planning process: Those processes required to establish the scope of the project, refine the objectives, and define the course of action required to attain the objectives that the project was undertaken to achieve.
Project schedule: An output of a schedule model that presents linked activities with planned dates, durations, milestones, and resources.
Scope: The sum of the products, services and results to be provided as a project.
Work Breakdown Structure(WBS): A hierarchical decomposition of the total scope of work to be carried out by the project team to accomplish the project objectives and create the required deliverables.
